Greetings team,
I have a question and I know that I am doing this incorrectly which is leading to my problem.

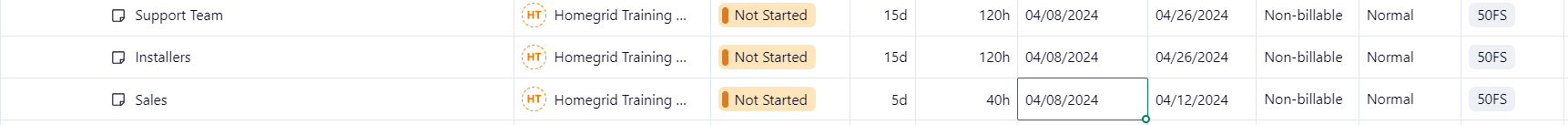

In wrike, I have 3 training tasks.

These have been set to two predecessors.
I have removed one of those predecessors since the training tasks are no longer dependent on this. This should bring in the schedule for those tasks by several months.

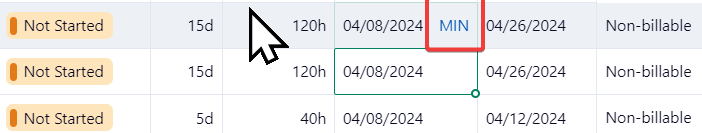

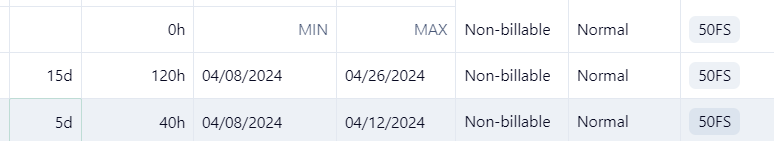

However, I have noticed that wrike does not automatically adjust the start date and due date. I discovered that if I select the "min" or "max" button that the start and due date will automatically update.

This typically works for me when I make changes to the schedule requiring tasks down the chain to be updated.
However, when I click this, I end up blowing away the duration, start, and end dates.

This automatically backlogs the tasks requiring me to manually key in everything. I'm not able to get the task to automatically schedule either.
I apologize, I come from the MS Project world where dates automatically get adjusted when I make changes like this.
My question is two fold:
1. What am I doing wrong?
2. What is the best way to get dates to automatically update when I adjust predecessors?
Thank you for any help!
